BH1 – BH31
Home/Our Work/House Extension Rewire — Milford-on-Sea
Case Study // Full Electrical Installation · House Extension

High-Spec
Extension
Milford-on-Sea

A 6-week complete electrical installation for a five-bedroom detached house extension in Milford-on-Sea — swimming pool controls, Zappi EV charger, electric UFH, induction hob, pergola, 50-metre remote tree lighting, and a dual-row Hager consumer unit. Part P notified.

Milford-on-Sea, SO41
5-Bed Detached — High Spec
6 Weeks · 2 Engineers
Nov 2022 – Jan 2023
Hager Dual-Row CU
Zappi EV Charger
EIC + Part P Notified
6
Weeks on site
first & second fix
7
Distinct zones
wired & commissioned
50m
Remote switching run
for tree feature light
2
Engineers throughout
first & second fix

Extending a High-Spec Home

The client was adding a substantial extension to their five-bedroom detached house in Milford-on-Sea — an outdoor swimming pool, a new kitchen and utility room, a bathroom, a garage with EV charging, and a garden with a pergola, external barbecue station, and feature tree lighting. The existing property needed partial rewiring and modification to integrate with the new installation.

At this level of specification, the electrical design has to account for everything simultaneously: load calculations across the new and existing circuits, zone compliance in the bathroom, outdoor IP ratings for the pergola and pool circuits, and a consumer unit robust enough to handle the full load of a property running induction cooking, underfloor heating, EV charging, and pool equipment concurrently.

The client had been recommended SC Electric. They were building something to last, and they needed an electrician who would treat the specification the same way.

HAGER
Consumer Unit — Hager Dual Row

The installation is centred on a two-row Hager consumer unit fitted with RCBOs — individual residual current protection on each circuit rather than shared RCD banks. This means a single fault on one circuit cannot trip the rest of the property. On a high-spec home with a pool, EV charger, and underfloor heating all running simultaneously, this is the correct approach. MCBs power the external concrete barbecue station separately.

Project Summary
AddressKeyhaven Road
AreaMilford-on-Sea, SO41
Property5-Bed Detached
SpecHigh-end extension
Duration6 weeks on site
First fix3 weeks
Second fix2 weeks
Crew2 engineers
CompletedJanuary 2023
EIC Issued
Part P✓ Notified
NAPIT Accreditation
SchemeNAPIT
Member No.69418
ScopeDomestic & Commercial

Room By Room

Seven distinct zones, each with its own electrical requirements. Every circuit planned, installed, and tested across first and second fix.

🍳

Kitchen

  • Induction hob — island unit
  • Double oven & warming drawer
  • Wine cooler circuit
  • Fridge & freezer spurs
  • USB sockets — island
  • Interlinked heat detector
  • Pendant lighting
  • Recessed downlights
🛁

Bathroom

  • Electric shower circuit
  • Electric underfloor heating mat
  • UFH thermostat
  • IP-rated lighting
  • Extractor fan circuit
  • Electric mirror connection
🚗

Garage

  • Zappi EV charger installation
  • Socket circuits
  • Lighting circuits
📺

Living Room

  • TV aerial socket
  • Data sockets — multiple locations
  • CO₂ detector — solid fuel fireplace
  • Multi-way switching
  • Lighting circuits
🔧

Utility Room

  • Ethernet switch — wired internet hub
  • Data runs — house + garden room
  • Swimming pool controls
  • Pool lighting circuits
  • Wet UFH thermostat — extension
  • Dedicated boiler power feed
🌿

Garden & External

  • Electric pergola roof connection
  • Pergola lighting installation
  • External barbecue station — MCB fed
  • Outdoor kitchen sockets — IP rated
  • Tree feature light
  • 50m remote switching run
  • 2-way & intermediate switching

How a 6-Week Job Works

A project of this scale runs in two distinct phases. First fix happens while walls are still open — all cable routes, back boxes, and conduit are installed before plastering begins. Second fix follows once the building work is finished: accessories are fitted, circuits are tested, and the consumer unit is commissioned.

Getting first fix right determines everything that follows. A cable routed incorrectly in week one becomes a problem in week five. On a high-spec project like this, precision at first fix is not optional — there is no room to go back through finished plasterwork.

01
Phase One

First Fix

3 weeks · 2 engineers

All cable routes installed to each room and zone. Back boxes, conduit, and sub-main cables run before plastering. Consumer unit position established. Pool, pergola, and tree light sub-mains run to garden. Data and ethernet infrastructure roughed in.

02
Phase Two

Second Fix

2 weeks · 2 engineers

All accessories fitted across every zone. Hager consumer unit populated and labelled. RCBOs terminated and tested individually. Zappi EV charger commissioned. UFH thermostats programmed. Pool controls connected and tested. Tree light remote switching verified at 50 metres. EIC issued on completion.

Consumer Unit
BrandHager
ConfigurationDual row
ProtectionRCBOs per circuit
External feedMCBs — BBQ station
EV chargerZappi — dedicated
Notable Installations
Induction hob✓ Island
Electric UFH✓ Bathroom
Wet UFH control✓ Extension
Pool controls✓ Utility room
Wired ethernet✓ House + garden
Tree light remote✓ 50m run
Pergola electrics✓ Roof + lighting
Zappi EV charger✓ Garage
CO₂ detector✓ Fireplace
Heat detector✓ Interlinked

In Progress & Completed

First fix, second fix, and finished installation — open-plan kitchen lighting, pendant positions, recessed downlights, living room circuits, and external socket installation for the outdoor kitchen.

Completed kitchen lighting — open plan extension
01Completed kitchen lighting — open plan extension

Recessed downlights — first fix
02Recessed downlights — first fix

Kitchen rewire — in progress
03Kitchen rewire — in progress

Living room lighting — installed
04Living room lighting — installed

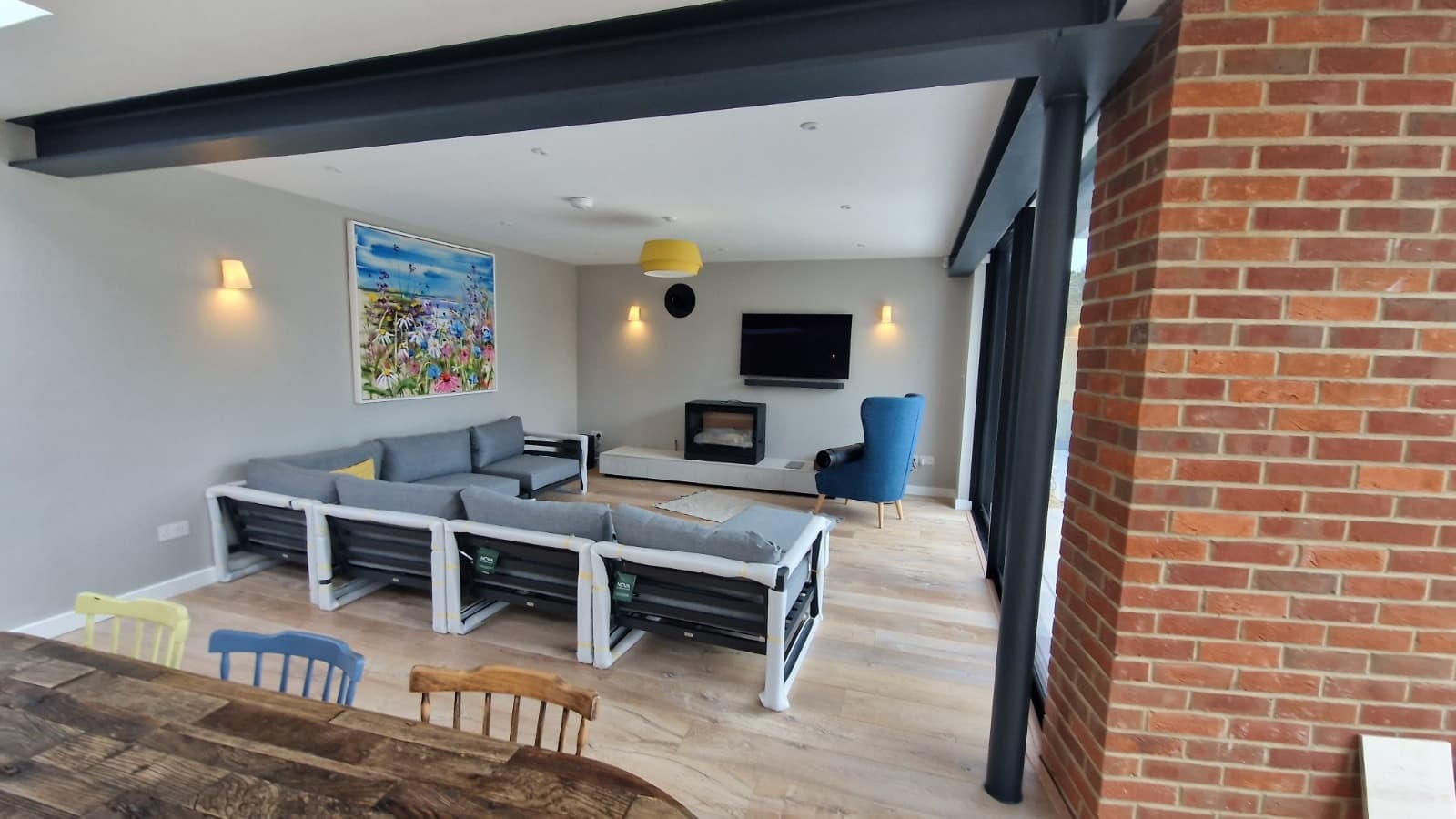

Open-plan extension — rewire overview
05Open-plan extension — rewire overview

Pendant lighting positions — kitchen island
06Pendant lighting positions — kitchen island

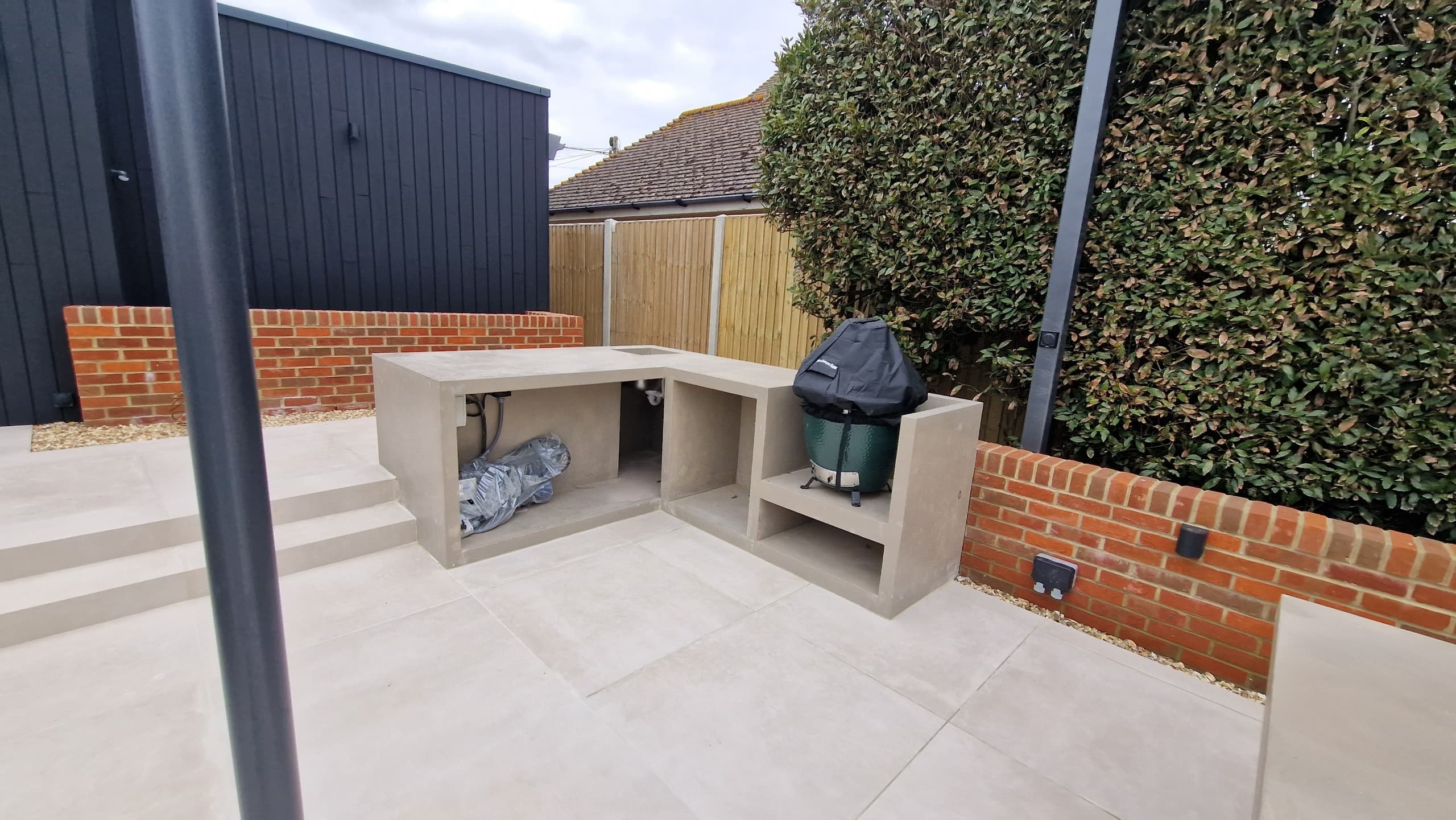

Outdoor kitchen — IP-rated external socket installation
07Outdoor kitchen — IP-rated external socket installation
"

When a client is building a swimming pool, a pergola, and an outdoor kitchen on top of a full extension, the electrical spec touches everything. The job is not just connecting things — it's understanding how all of it runs at once and designing a distribution board that handles it without compromise.
